Home / Case Studies / Red Sea Film Festival
Case Study · Events · Saudi Arabia

Ten Days, Three Million Square Feet, Zero Outages

EZELINK designed, built and operated the entire network for the Red Sea International Film Festival in Jeddah — Wi-Fi 7 across eight sites, 5 Gbps of core traffic in high availability, and separate networks for press, VIPs, broadcast and the public, all inside an extremely short build window.

Client  Red Sea Film Foundation Location  Jeddah, Saudi Arabia Dates  4–13 December 2025 Footprint  3 Million Sq Ft
Packed auditorium at the Red Sea International Film Festival in Jeddah, with the main screen lit
3M
Sq Ft Footprint
5Gbps
Core, High Availability
8
Installation Sites
Wi-Fi 7
802.11be
The Challenge

The Whole World's Media, Filing at Once

The Red Sea International Film Festival is one of the region's most significant cultural events: ten days of screenings, workshops, panels and red-carpet nights drawing global film professionals, celebrities, international press and VIP guests to Jeddah.

That audience creates an unusual network problem. Most venues worry about download speed. Here the traffic that mattered ran the other way — broadcast feeds going out, press filing to deadline, celebrities posting live to millions of followers. Upload capacity, not download, decides whether the event looks well-run to the outside world.

Those user groups also cannot share a network. Press need guaranteed throughput. VIPs need secure, differentiated access. Broadcast needs protected bandwidth that nothing else can touch. And the public need enough of a connection that a red-carpet crowd of thousands doesn't collapse the whole thing.

All of it had to be designed, built and proven across eight sites and three million square feet — indoors and out — inside an implementation window the project team describes as extremely limited.

  • Upload-dominant traffic: live broadcast, press filing and social posting
  • Four distinct user groups needing genuinely separate networks
  • Peak density during screenings, panels and award nights
  • Indoor theatres and outdoor activation spaces across 3 million sq ft
  • A fixed opening night and a very short build window
Culture Square The Souk Red Carpet Press Lounges Screening Theatres Outdoor Activations
Empty festival screening theatre in Jeddah with tiered red seating and a wide screen
What you design against: a theatre that has to work perfectly the first time it fills.
The Solution

A Core That Cannot Fail, and Four Networks Above It

The core was built for high availability from the start, carrying 5 Gbps in HA mode behind a next-generation firewall — with ISP-agnostic redundancy, so the festival was not dependent on any single provider staying up for ten days.

Above it we deployed a multi-layer wireless backbone using high-density access points optimised for 802.11be — Wi-Fi 7 — for the capacity and latency that live media work demands. Then the networks were separated by purpose rather than by location, with quality-of-service rules prioritising mission-critical traffic: live feeds and broadcast uploads take precedence over everything else, always.

The scope went well beyond WiFi. This was end-to-end IT infrastructure — LAN and WLAN, plus Dante for audio over IP and NDI for video over IP. Those are professional broadcast protocols with strict latency and timing requirements, and carrying them properly is a different discipline from delivering guest internet.

Public Access

Open guest WiFi through a branded login, working across every festival location.

Media Operations

Guaranteed throughput for press filing, uploads and live broadcast feeds.

Guest & VIP

Secure, credential-managed access for talent and invited guests.

Administrative & Staff

Isolated operational network for festival management and production teams.

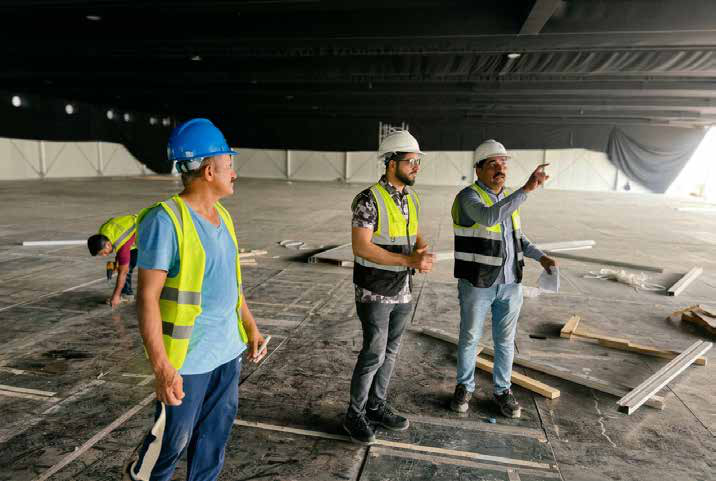

EZELINK engineers surveying a bare festival venue during fit-out, wearing hard hats and hi-vis
Site survey during fit-out, before the venue existed as a venue.

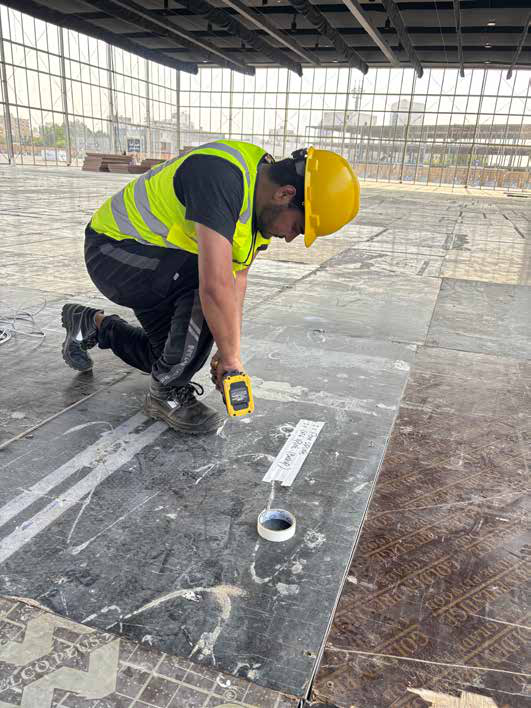

Engineer marking out cable routing on the floor of a festival venue under construction
Cable routes measured and marked before a single access point went up.
Delivery

Five Phases, One Immovable Date

Delivery was led by Hassan Mumtaz, Head of Projects at EZELINK, with his team on the ground from survey through de-rig. The sequence never varies on an event build, because the deadline never moves — what varies is how much of it you can compress without leaving the testing until the audience arrives.

01

Planning & Design

Requirements gathering with the festival team, then physical site surveys across every venue.

02

Infrastructure Deployment

Access point placement, cabling and installation across all eight sites, completed before the festival opened.

03

Testing & QA

Load testing, failover checks and security audits — proving the design under stress rather than assuming it.

04

Festival Operations

On-site engineers throughout all ten days, live support and continuous performance tuning.

05

Post-Event Analysis

Network usage reporting and a documented review for the next edition.

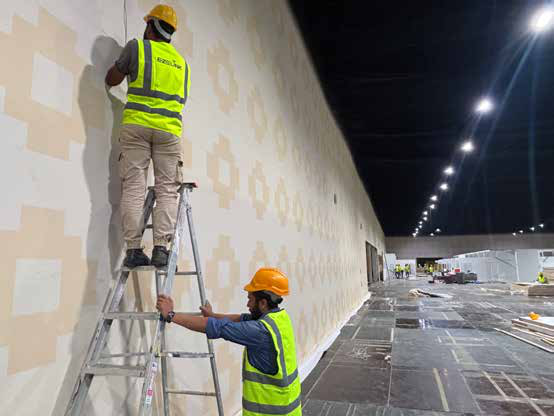

EZELINK engineers installing wireless hardware on a festival venue wall from a ladder
Installation across the venue — EZELINK engineers, not subcontractors.

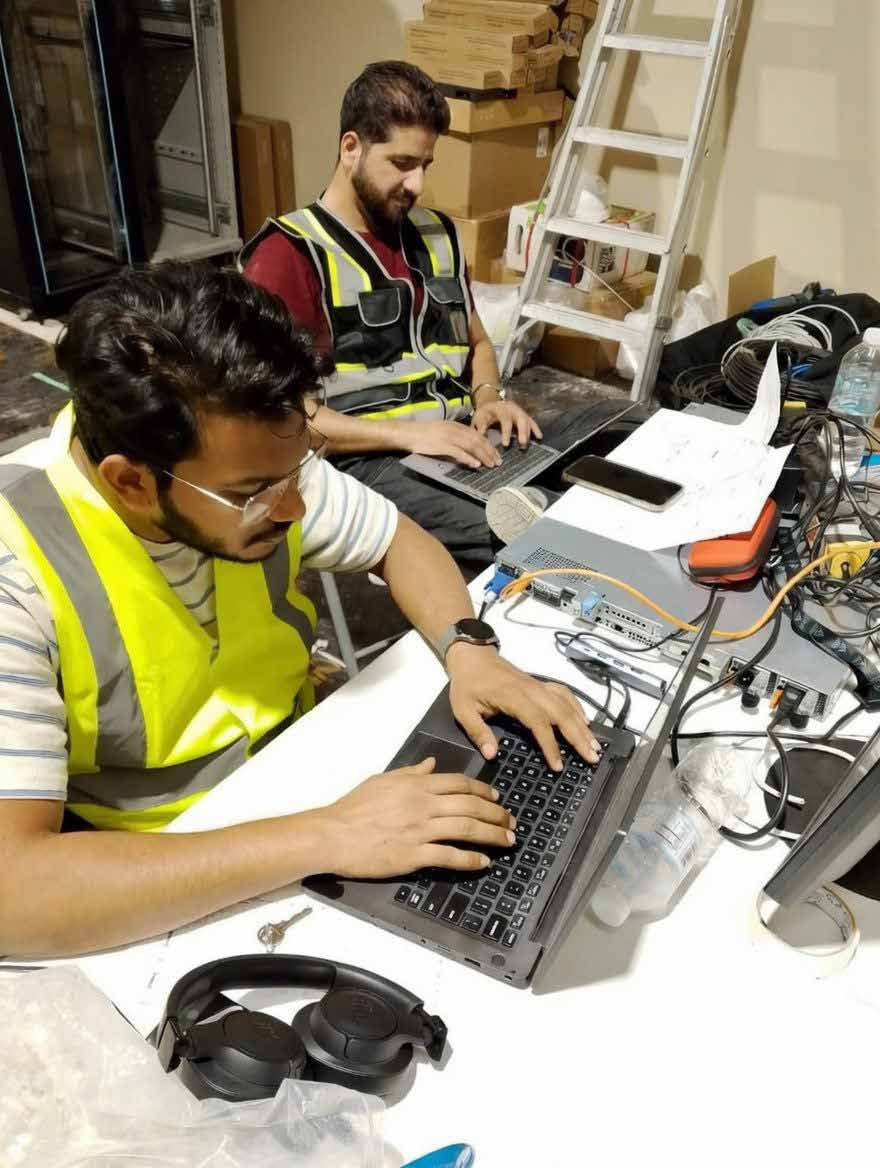

EZELINK engineers configuring network switches on site during the festival build
Configuration and testing on site, working around an active fit-out.
Deployment

The Numbers Behind the Build

Client
Red Sea Film Foundation
Event
Red Sea International Film Festival, 4–13 December 2025
Footprint
3 million sq ft
Installation sites
8
Core
5 Gbps in high availability, next-gen firewall
Redundancy
ISP-agnostic
Wireless
High-density 802.11be (Wi-Fi 7)
Scope
LAN · WLAN · Dante · NDI · Branded portal · 24/7 NOC · On-site engineers
The Results

No Declared Outages, Across Ten Days

The network carried thousands of simultaneous connections through the festival with no declared outages, sustaining the throughput that uninterrupted video upload and live media reporting require.

The measure that matters for a cultural event is not a number on a dashboard, though — it is whether the coverage happened. International media teams posted and filed instantly. Talent shared to their own audiences from the red carpet without waiting. And access held up equally across indoor theatres and outdoor spaces, which on a site of this size is the harder half.

  • No declared outages across the full ten-day festival
  • Thousands of concurrent connections sustained at peak
  • Uninterrupted video upload for international media teams
  • Consistent coverage indoors and outdoors — red carpet, Culture Square and the Souk
  • Daily health reporting and peak-load analytics throughout
Red Sea International Film Festival 2025 signage in Jeddah with festival representatives
Jeddah, December 2025 — ten days, eight sites, one network.

"Ezelink's team was responsive and proactive throughout the festival — a true partner in ensuring smooth operations."

IT Director · Red Sea Film Foundation
Explore

The Solutions Behind This Project

Opening Night Doesn't Move
